Q1 · UPSC Civil Services Mains 2022 · GS III · 10 marks · 3 min read

← Q6 Q12 →

Why is Public Private Partnership (PPP) required in infrastructural projects ? Examine the role of PPP model in the redevelopment of Railway Stations in India.

Topic: Infrastructure. Syllabus: Infrastructure: Energy, Ports, Roads, Airports, Railways etc. Same official PYQ from year-wise 2022 and Infrastructure.

Revision summary

PPP is needed because public budgets cannot finance all long-life infrastructure on time, and private partners bring capital and operating skill. Risk and revenue are split by contract: the State keeps policy and often land; the concessionaire takes construction and commercial risk. Railway station redevelopment uses that split: trains stay with Indian Railways; buildings and retail can be private. IRSDC and railway SPVs bid packages; Habibganj (Rani Kamalapati) is an early example. PM Gati Shakti is meant to connect those stations to other modes. Small-town stations may still need public viability support.

Model answer

Copper italics in this answer — like this — are the key facts. Each one is unpacked in the Facts & figures rail.

Introduction

Roads, rails, ports and stations cost more than one budget year can comfortably carry. Public-private partnership (PPP) brings private capital, construction skill and operating discipline into assets the State still owns or regulates. Railway station redevelopment is a visible test of that bargain: land and passenger rights stay public; buildings, retail and maintenance can be private.

Body

Why PPP is required in infrastructure

  • Public funds must also pay for welfare, defence and interest; they cannot finance every greenfield corridor on time.
  • Private firms bring design-build-operate experience, faster procurement of plant, and a stake in keeping the asset working after inauguration.
  • User charges, land monetisation and availability payments can spread cost across decades instead of one vote of account.
  • Risk of delay, cost overrun and demand shortfall can be allocated by contract: construction to the concessionaire, policy and land to the State.
  • India already uses PPP in highways (Hybrid Annuity Model), ports, airports and some urban metro stretches; stations are the same logic applied to passenger nodes.
  • PM Gati Shakti (2021) is the Union’s multi-ministry map so those PPP assets actually connect, not sit as isolated packages.

Role of PPP in railway station redevelopment

  • Indian Railways holds large city-centre land. Redevelopment aims to turn a crowded platform into a multimodal hub with concourses, lifts, toilets, parking and last-mile links.
  • Under station redevelopment, a private partner typically designs, finances and builds the station and commercial real estate, then recovers cost from retail, offices, hotels and advertising while Railways keeps train operations.
  • The Indian Railway Stations Development Corporation (IRSDC) and later railway special-purpose vehicles were created to bid out such packages; Habibganj (Rani Kamalapati) in Bhopal is an early completed example, with Gandhinagar and other stations in the pipeline.
  • PPP is meant to raise passenger amenity without a matching jump in the railway capital budget, and to plug stations into city buses, metro and Gati Shakti logistics.
  • Limits are real: land title, heritage buildings, fare politics, and the fact that a station’s commercial rent may not pay for a full rebuild in a small town. Those stations still need public money or a viability gap.

Comment

  • PPP is required where the asset is large, long-lived and can earn or save cash. It is not a substitute for a clear public specification of safety and access.
  • Station redevelopment works when the concession is bankable and the city can absorb the commercial floor; it fails if it is only a real-estate play that ignores platforms.

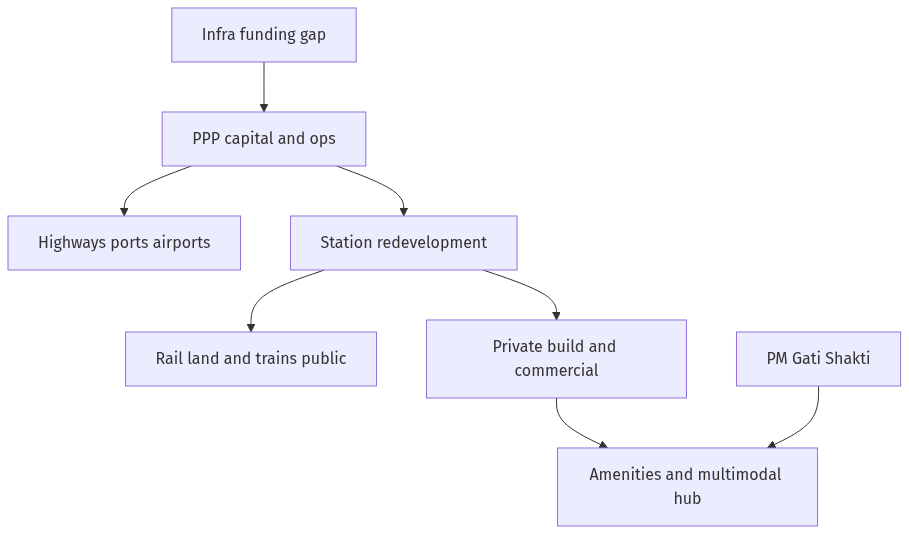

Flow diagram

Flow diagram

Conclusion

Infrastructure needs PPP because the State cannot fund and run every long-life asset alone. Station redevelopment is that model at the passenger door: private build and commercial recovery, public trains and land. It succeeds only where contracts, city planning and Gati Shakti connectivity move together.
